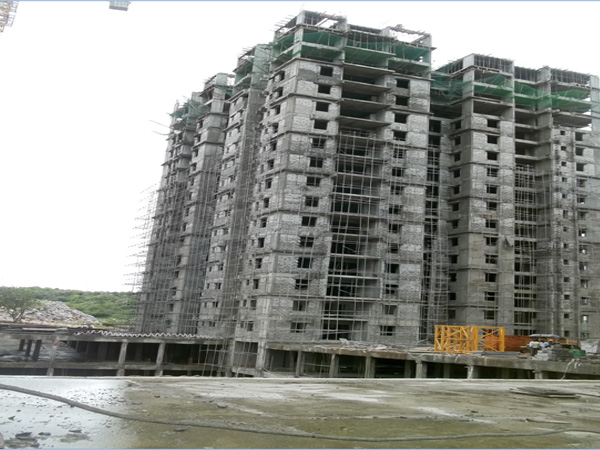

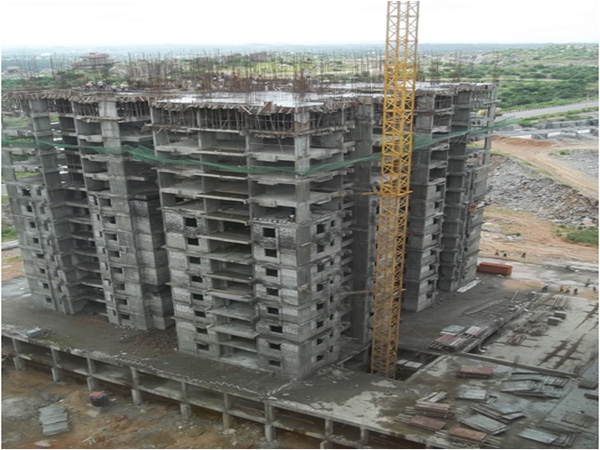

BLOCK-C : 13th FLOOR SLAB CONCRETING COMPLETED ON 15th Aug 2012

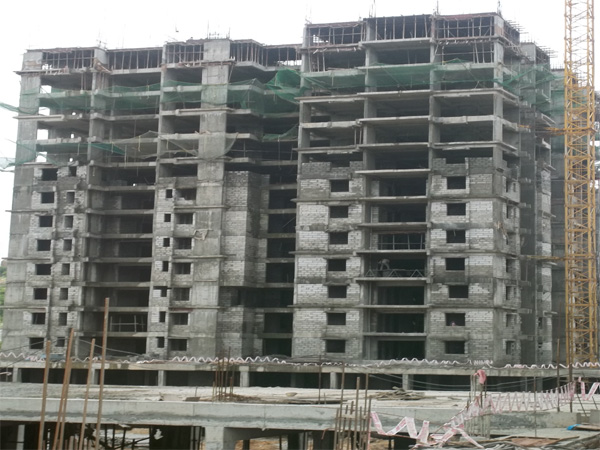

BLOCK-B: 15th FLOOR SLAB CONCRETING COMPLETED ON 24th Aug 2012

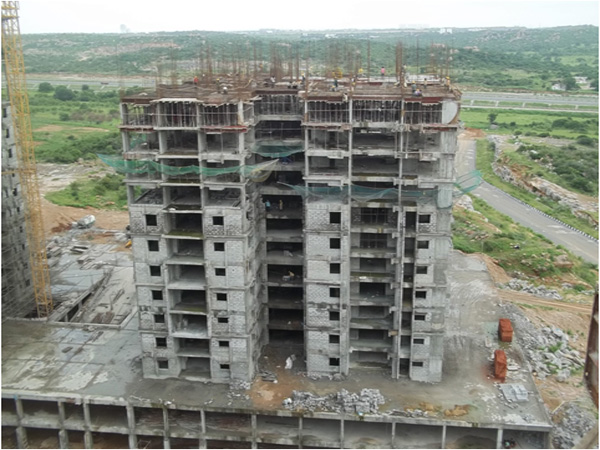

BLOCK-D: 9th FLOOR SLAB CONCRETING COMPLETED ON 22nd Aug 2012

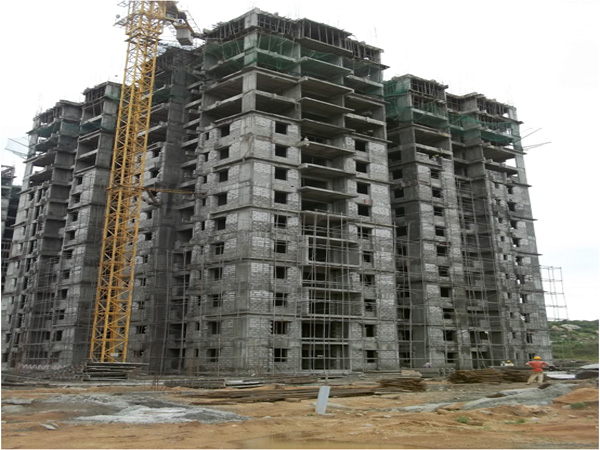

BLOCK-A: 11th FLOOR SLAB CONCRETING COMPLETED ON 17th Aug 2012

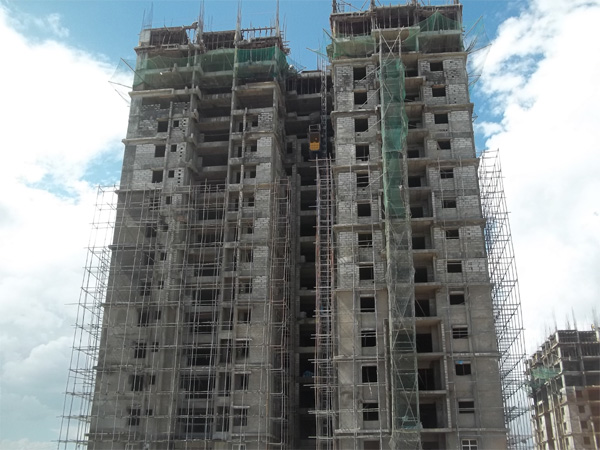

BLOCK-B: BLOCK WORK COMPLETED UP TO 11TH FLOOR AND WORK IN PROGRESS AT 12TH & 13TH FLOOR, EXTERNAL PLASTER WORK IN PROGRESS
BLOCK-C: BLOCK WORK COMPLETED UP TO 9TH FLOOR AND WORK IN PROGRESS AT 10TH FLOOR, EXTERNAL PLASTER WORK IN PROGRESS
BLOCK-A: BLOCK WORK COMPLETED UPTO 6TH FLOOR AND WORK IN PROGRESS AT 7TH FLOOR
BLOCK-D: BLOCK WORK COMPLETED UPTO 5TH FLOOR AND IN PROGRES AT 6TH FLOOR.
CLUB HOUSE & SWIMMING POOL AREA: PCC & FOUNDATION REINFORCEMENT WORKS IN PROGRESS

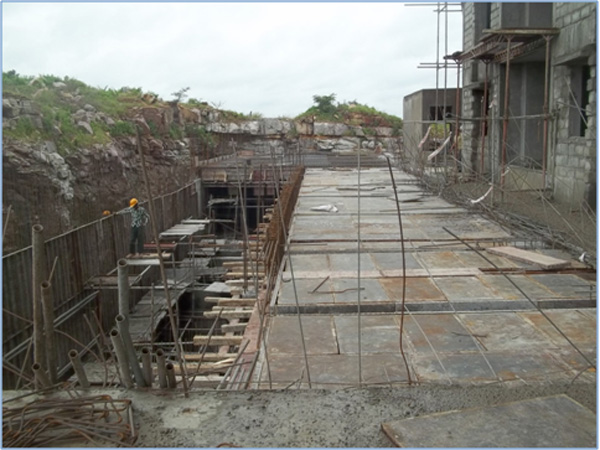

STP: CELLAR SLAB SHUTTERING & REINFORCEMENT WORKS IN PROGRESS
PLUMBING WATER LINE TESTING WORKS IN PROGRESS AT TOILETS OF ALL THE FOUR BLOCKS

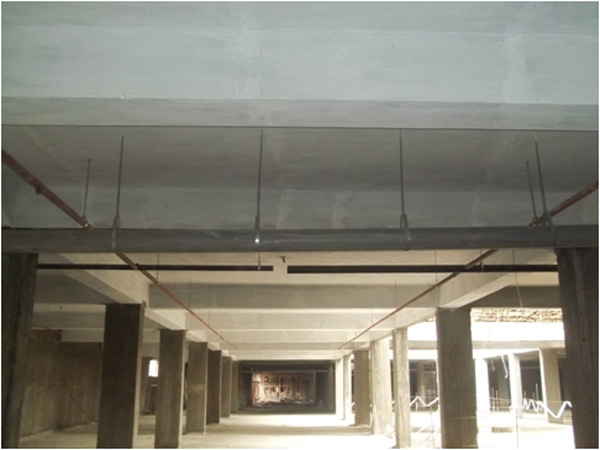

FIRE FIGHTING & PLUMBING WASTE/SOIL PIPE LAYING WORKS IN PROGRESS AT CELLAR LEVEL
